Current Progress
Construction of the city-wide network is ongoing. We expect the whole project to take a few years to complete. The project plan is designed to roll out in phases as the network is built, neighborhood by neighborhood – or Fiberhood by Fiberhood.
Completed
- Underground Passings: Downtown, Centennial Park, Historic, Triangle, Rosa Parks, Holland High, and Industrial South Fiberhoods
- Aerial Passings: Downtown, Centennial Park, Historic, Triangle, and Rosa Parks Fiberhoods
- Testing and Finalization of Passings: Triangle Fiberhood
- Downtown: Upgrades to Shared Gig customers
In Progress
- Aerial passings: Holland High Zone
- Testing and Finalization of Passings: Rosa Parks Zone
- Downtown: Upgrading Shared Gig customers to Holland BPW Fiber
- Drop Construction: Historic, Centennial, Triangle and Downtown Fiberhoods
- Service activation: Historic, Centennial, Triangle, and Downtown Fiberhoods
The Construction Process

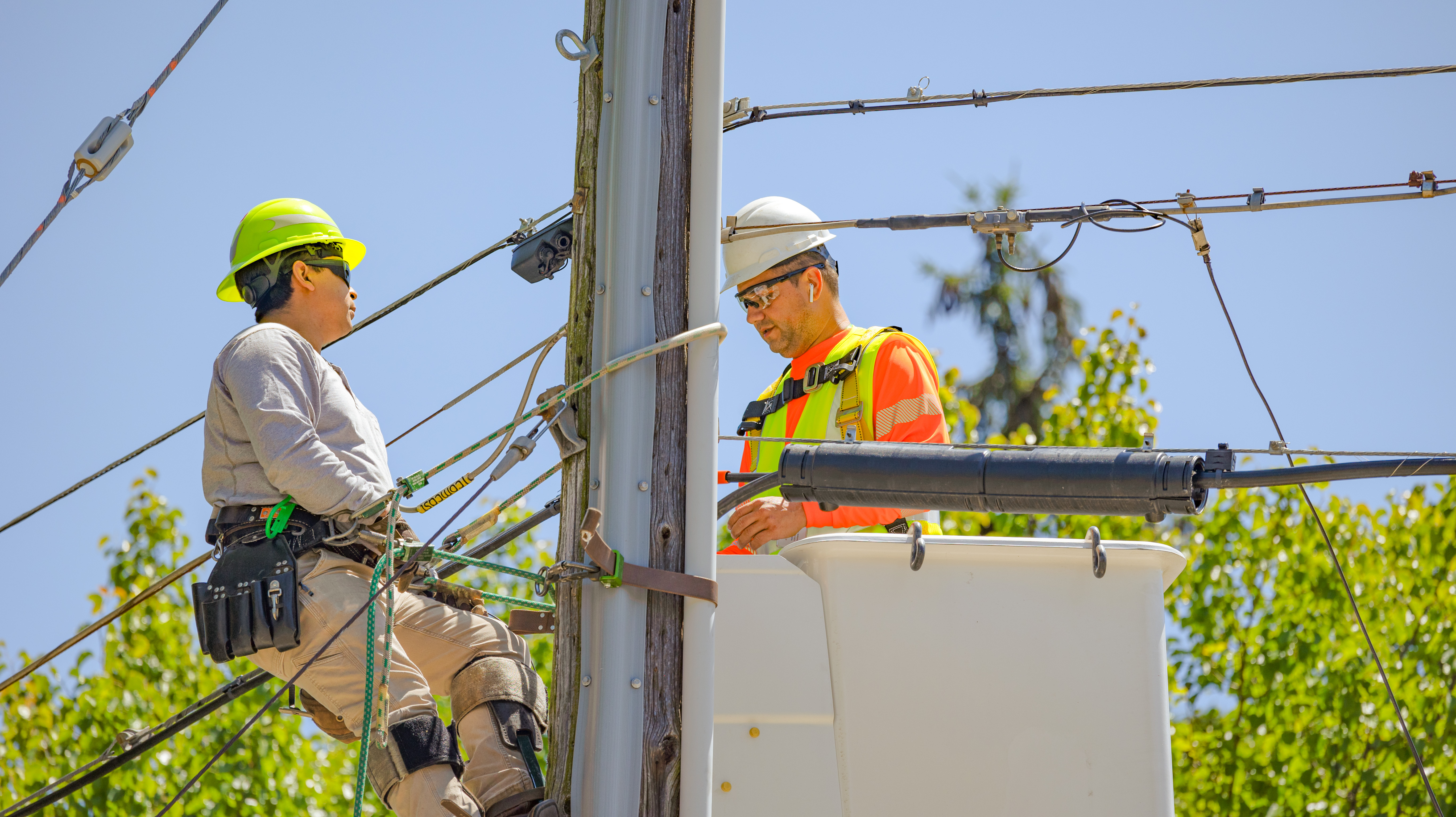

Crews are constructing the passings network throughout the City of Holland. The passings network consists of the fiber lines that go past every home, making fiber connectivity available to everyone in the City of Holland. Some of the fiber will be underground and some will be overhead.
Just as a water main goes past every home to provide access to water, a fiber optic passing goes past every home to provide access to data. As the passing network is built, neighborhood by neighborhood – fiberhood by fiberhood – service will roll out as it becomes available.
Fiber passing - goes past the home.
Fiber drop - goes to the home.
Passings Construction
Build out the underground and aerial passings.
Test & Finalize
Test and finalize the passings.
Drop Construction
Build out drops from the passings to homes of customers who have elected BPW fiber internet services.
Activate Service
Service installation and activation.
Timeline
December 2024
Construction
Rosa Parks Fiberhood
Passing network completed in the Rosa Parks Fiberhood. Service applications open.
December 2024
October 2024
Construction
Downtown Fiberhood
Passing network completed in the Downtown Fiberhood. Service applications open.
September 2024
Construction
Triangle Fiberhood
Passing network completed in the Triangle Fiberhood. Service applications open.
September 2024
Aug 2024
Construction
Centennial Fiberhood
Passing network completed in the Centennial Fiberhood. Service applications open.
Jun 2024
Construction
Historic Fiberhood
Passing network completed in the Historic Fiberhood. Service applications open.
Jun 2024
30 Apr 2024
Engagement
Community Update Meeting
A public meeting to inform community memebers about the services offered and progress of the project.
Jan 2024
Construction
Construction Started
Passing network construction started. Work kicked off in the Historic Fiberhood at Kollen Park.
Jan 2024
Dec 2023
Engagement
Building Fiberhoods in Holland
New branding campaign launched for Holland BPW Fiber.
Nov 2023
Partners
Fulfillment Services Selected
Holland BPW selects ITG as the service fulfillment contractor.
Nov 2023
23 Oct 2023
Engagement
New Holland BPW Fiber Internet Web Page
Holland BPW launched a new web page. Interest form opened for all Fiberhoods.
14 June 2023
Partners
EX2 Kick Off Meeting
Holland BPW and EX2 align goals, plans, and communication.
14 June 2023
22 May 2023
Partners
Design/Build Engineer Selected
Board of Directors accepted the recommendation to select EX2 as the Design/Build Engineer.
Nov 2022 - Apr 2023
Design
High Level Network Design
Engineering and design of the city-wide build to ensure efficient and accurate plans for the project.
Nov 2022 - Apr 2023
10 Oct 2022
Partners
Owners Engineer
City Council approved Owners Engineer contract with CTC.
2 Aug 2022
Vote
Holland City Fiber Vote Passed
Residents of the City of Holland voted to invest in expanding the community-owned fiber network.
2 Aug 2022
